7 Step Change Order Process to Get Contractors Paid Faster
All Quoting Resources

7 Step Change Order Process to Get Contractors Paid Faster

QuoteLock August 29, 2026
7 Step Change Order Process to Get Contractors Paid Faster

7 Step Change Order Process to Get Contractors Paid Faster

Contractor hands with tablet and tools on job site table

A change order is the formal contract amendment that records a scope change, its price, and its effect on the schedule. The moment you spot a deviation from the plans, three actions protect your money: document what happened with photos and a written note, send contractual notice before any deadline passes, and price the work before you start it, not after.


TL;DR:

  • Clearly document all deviations immediately with photos and notes to support both pricing and dispute resolution.
  • Obtain signed change orders before proceeding with scope changes to ensure payment and legal protection.
  • Price change orders based on actual costs, including labor, materials, subcontractors, and equipment, with explicit markup agreements.
  • Act within your contract’s notice window, typically 7 to 21 days, to preserve claim rights and avoid waiver issues.
  • Maintain comprehensive, organized records such as photos, RFIs, logs, quotes, and schedule impacts to strengthen your position in disputes.

Table of Contents

What a change order is versus a request or directive

A change order is a signed, bilateral agreement modifying the contract. A change order request (COR) is your proposal, pricing and all, waiting for the owner’s signature. A construction change directive (CCD), common in AIA A201 and similar forms, orders you to proceed with work before price or time is settled.

The difference decides who gets paid and when. An executed change order guarantees your price. A COR is just an ask. A CCD requires you to perform now and argue value later, which is exactly why entitlement depends on paperwork you generate in the moment, not memory you reconstruct in month six.

If you get directed to proceed without agreement, do the work, but document everything and issue a written reservation of rights the same day. Refusing directed work on a public contract can put you in breach; silently eating the cost puts you out of pocket. ToolGrit’s change order management guide confirms this is standard practice under AIA and ConsensusDocs forms: proceed, but preserve your right to later valuation.

The change order process, step by step

AACE International’s recommended practice outlines a staged change management sequence, and it maps closely to what works in the field: identification, preliminary submittal, formal COR, approval, execution, and claims if needed. Here’s how that plays out on an actual job.

  1. Identify and document immediately. The moment a deviation surfaces, whether it’s a differing site condition or an owner-requested upgrade, take dated photos, log it in your daily report, and note who directed the change verbally.
  2. Decide: preliminary notice or full pricing? If the scope isn’t fully defined yet, send a preliminary COR flagging the issue and reserving your rights. Full pricing comes once quantities and labor are known.
  3. Assemble the priced package. Build your cost breakdown, attach supporting quotes, and reference the RFI or directive that triggered the change.
  4. Negotiate with a paper trail. Keep every revision, every email, and every verbal concession in writing. Verbal agreements evaporate; email threads survive audits.
  5. Get it issued formally. Push for a signed change order, not a handshake. If the owner insists on proceeding first, get a directive in writing.
  6. Implement and update your systems. Once approved, update the project schedule, revise cost reports, and issue any procurement actions tied to new materials or subcontractor scope.
  7. Close out the COR. Confirm final quantities, reconcile any T&M tickets, and file the executed document with the rest of your contract record.

Construction Front’s breakdown of the change order lifecycle frames this as a five-stage cycle, and the pattern holds across public and private work: skip the pricing or negotiation stage, and you inherit disputes at closeout that cost more than the change itself.

How to price change orders without leaving money on the table

Pricing disputes are one of the most common friction points in change order management, largely because contractors and owners disagree on what counts as a direct cost versus an indirect one. Research published in the Practice Periodical on Structural Design and Construction found that ambiguity over allowed markups drives a large share of change order conflict, and recommends specifying costing rules in Division 1 of the project manual before work even starts.

A defensible COR itemizes:

  • Added labor hours at your actual burdened rate
  • Materials at invoice cost plus any documented price escalation
  • Subcontractor quotes, attached as backup
  • Equipment time, whether owned or rented
  • Remobilization costs if the change interrupts sequencing
  • Waste disposal or hauling tied directly to the changed work
  • Applicable sales or use tax
  • Credits for any deleted work, calculated the same way as the added cost, never estimated

Overhead and profit markup should follow whatever percentage your contract specifies. If it’s silent, ShiftFlow’s pricing guide recommends stating your markup basis explicitly in the COR itself so there’s no ambiguity at review.

Pro Tip: When you delete one item and add another in the same change, price both sides independently instead of netting them in your head. Reviewers catch bundled math, and it slows approval every time.

For scope that’s genuinely uncertain, time and materials (also called force account) pricing works, but only with daily-signed tickets. Lump sum and unit pricing move faster when quantities are known upfront; not-to-exceed pricing gives the owner a ceiling while you finalize actuals.

Notice deadlines and what happens when work starts before agreement

Most contracts give you a narrow window, often 7 to 21 days, to give written notice of a change. Miss it, and many contract forms treat that as a waiver of your claim, no matter how legitimate the underlying cost. Check your specific contract; notice provisions vary by form and by owner.

  • Send written notice the same day you identify a potential change, even if pricing isn’t ready.
  • Confirm who holds signature authority. On public work, that’s often a resident engineer or procurement officer with a defined dollar threshold, above which the owner itself must sign off.
  • If work is directed before agreement, proceed, document daily costs, and issue a written reservation of rights immediately.
  • Follow up with a fully priced COR within the timeframe your contract specifies, typically 15 to 30 days after the directive.

Caltrans’ Construction Manual documents exactly this kind of delegated authority structure, including provisions for unilateral change orders when a contractor won’t sign. Public agencies use these mechanisms regularly, and knowing your project’s specific thresholds keeps you from getting steamroller by a memo you didn’t expect.

Documentation that actually holds up in a dispute

Entitlement, causation, and quantum, the three things AACE identifies as what owners expect you to prove, all live or die on your recordkeeping. Losing a change order argument almost never comes down to whether the work happened. It comes down to whether you can prove it happened, why, and what it cost.

  • Photos and video timestamped the day the condition was discovered
  • The RFI or directive that triggered the change, referenced by number
  • Daily logs noting labor, equipment, and weather if relevant
  • Supplier quotes and subcontractor pricing attached as backup, not summarized
  • A schedule fragment or time impact analysis (TIA) if the change affects the critical path

Construction Front recommends using separate cost codes for change order work the moment it’s identified, not after approval. That single habit makes your accounting system do the proof-gathering for you instead of forcing a reconstruction later.

Pro Tip: Keep a dedicated “pending changes” folder per project, digital or physical, and drop every scrap of evidence into it the day it appears. Six months later, you won’t remember which email thread had the supplier quote. The folder will.

Retention matters too. Keep the full evidence stack for the life of the contract plus your state’s applicable statute of limitations for construction claims, not just until final payment clears.

Who initiates, reviews, and signs off

Field superintendents and project managers usually spot the change first and draft the initial COR. On design issues, the architect or engineer typically reviews for scope accuracy before it moves to the owner or construction manager for cost review.

Signature authority depends on the contract and, on public work, on statutory delegation limits, sometimes a resident engineer can approve small changes outright while anything above a set dollar threshold requires the owner’s own signature. If someone refuses to sign, that’s your cue to issue a formal notice of dispute rather than let the work proceed undocumented. Caltrans’ delegation framework shows how public agencies structure this so approval doesn’t bottleneck on a single signature.

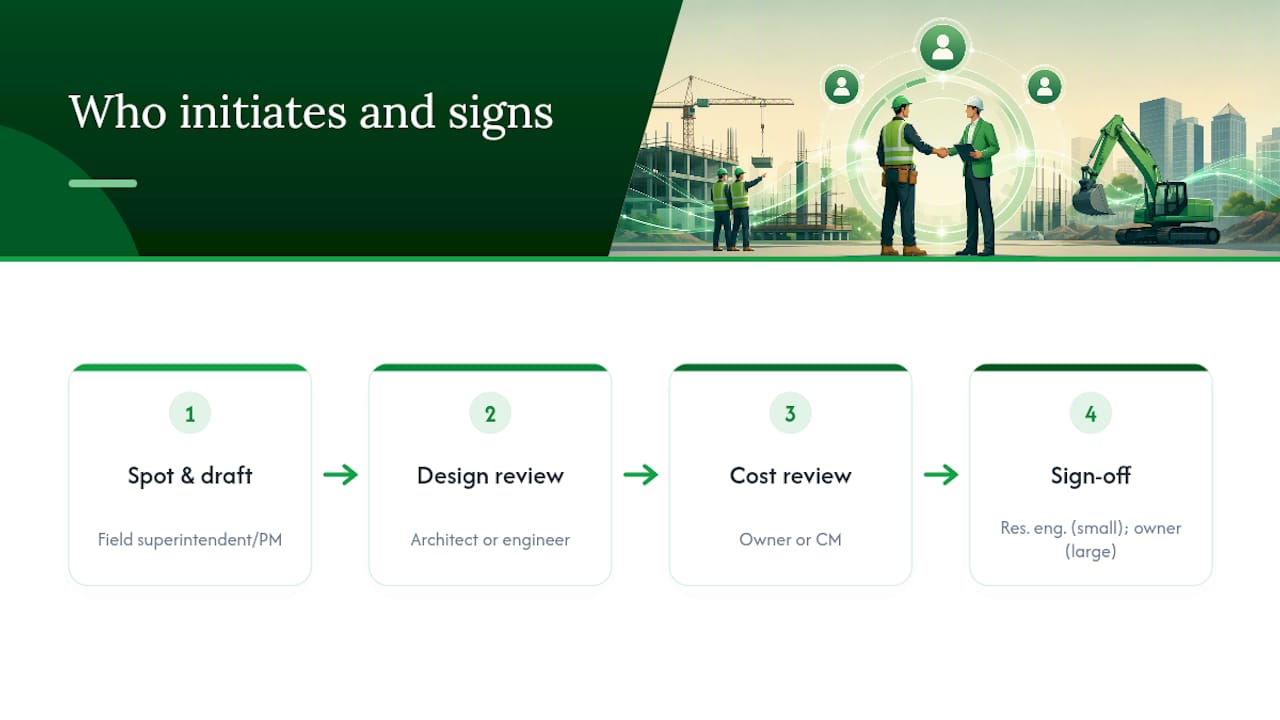

Who initiates, reviews, and signs off — overview diagram

Where change order disputes actually come from

Three triggers cause most fights: disagreement over how a cost was converted into a price, disagreement over whether the change actually affected the schedule, and notice that arrived too late to count. Each one is preventable with habits you can build into your normal week.

Hands using measuring tool on construction site

Contemporaneous records beat reconstructed ones every time, a daily log written the day of the event carries more weight than a narrative written for litigation. Submitting a TIA whenever a change plausibly touches the critical path protects your time claim before the schedule slips instead of after. Separate cost codes for every open COR keep your numbers clean enough to survive an audit.

When a dispute won’t resolve through normal negotiation, elevate it to a formal claim early rather than letting it linger. At that point, your daily logs, priced CORs, and schedule fragments become the entire case. If they’re incomplete, the claim usually loses regardless of merit.

A field checklist that speeds approval

Build the habit before you need it. On day zero of any potential change: snap the photo, file the RFI, open a separate cost code, get verbal confirmation from whoever’s on site, and send written notice before end of day.

Your submission package should include the priced COR, backup quotes, a reference to the triggering RFI or directive, and a schedule fragment if time is affected.

  • Photo and daily log entry, same day
  • RFI number referenced in every follow-up
  • Separate cost code opened before work starts
  • Written notice sent within your contract’s window
  • Priced COR with backup attached, not summarized

Pro Tip: Once a change order is approved, convert it into an invoice the same day. Delay is where cash flow problems start, not at the negotiation table. A quoting and invoicing tool built for trades can turn an approved COR into a sent invoice in minutes and flag it when the client views but doesn’t pay, closing the gap between “approved” and “paid.”

A late verbal direction taught me to never skip the paper trail

A superintendent once told me to “just proceed” on a foundation change with no signed CCD in hand. I sent a same-day email documenting the verbal direction, attached photos, and copied the owner’s rep. That email became the entire basis for a $40,000 recovery three months later. Copy this: document, notify, price, in that order, every time.

— Robert

Turning approved change orders into paid invoices faster

Every step in this guide gets you to one moment: an approved change order that needs to become cash in your account. That’s the gap where a lot of contractors lose time, chasing a client for sign-off, then rebuilding the same numbers into an invoice from scratch. QuoteLock’s construction quoting tools close that gap by letting you convert an accepted quote or approved COR directly into a branded invoice with one click, no re-entry, no separate software for clients to log into.

Quote-lock

If you’re processing more than a handful of change orders a month, the admin overhead adds up fast: tracking who’s seen a COR, who hasn’t responded, and who’s sitting on an approved change without paying. QuoteLock tracks when a client views your quote and sends automatic follow-up reminders so nothing stalls in someone’s inbox. For contractors running frequent scope changes on active jobs, that’s the difference between chasing paperwork and getting paid on schedule. Start a trial through QuoteLock’s quoting software and see how quickly an approved change order turns into cash in hand.

Where to check the rules that actually govern your project

Your contract form always wins over general guidance, so check it first for notice windows and pricing rules before applying anything here. For deeper reference, AACE International’s recommended practice lays out the full change management framework, Caltrans’ Construction Manual shows how public agencies structure approval delegation, and Maryland’s DGS change order guidelines illustrate typical institutional timelines. For consultancy-side documentation practices, Future Gen Consulting’s guide for Canadian owners and contractors is worth a read before your next dispute.

Sources

Send better quotes and win more jobs with QuoteLock

QuoteLock helps contractors create professional quotes, track customer views, get quotes accepted, arrange bookings, and turn accepted quotes into invoices — all in one simple workflow.
